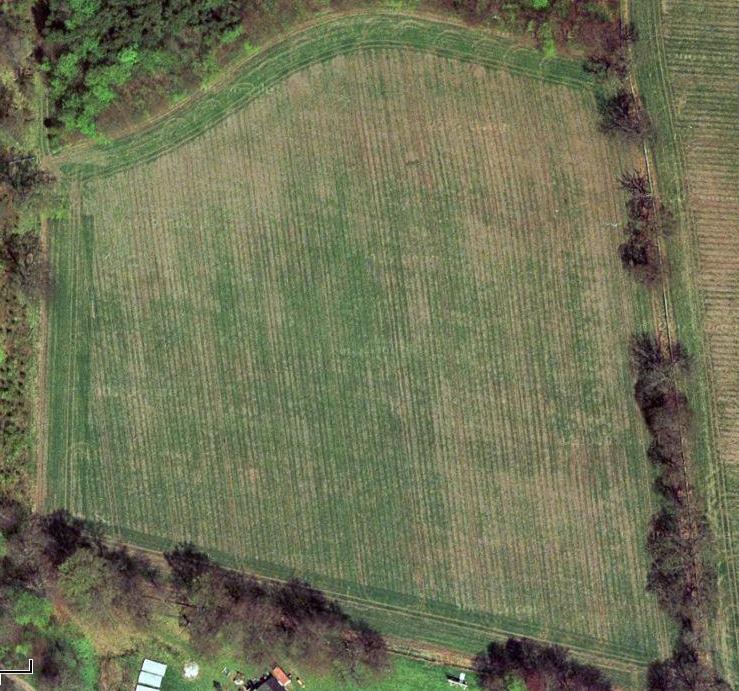

Current and Proposed Layout and Use of Lower Scroggie
The full proposal for the
development of
Timescale |
Details of Work |
May 2014 |
Agree project parameters, perform site surveys and submit planning and funding applications |
August 2014 |
Subject to above being successful, create new entrance to |
Early September 2014 |

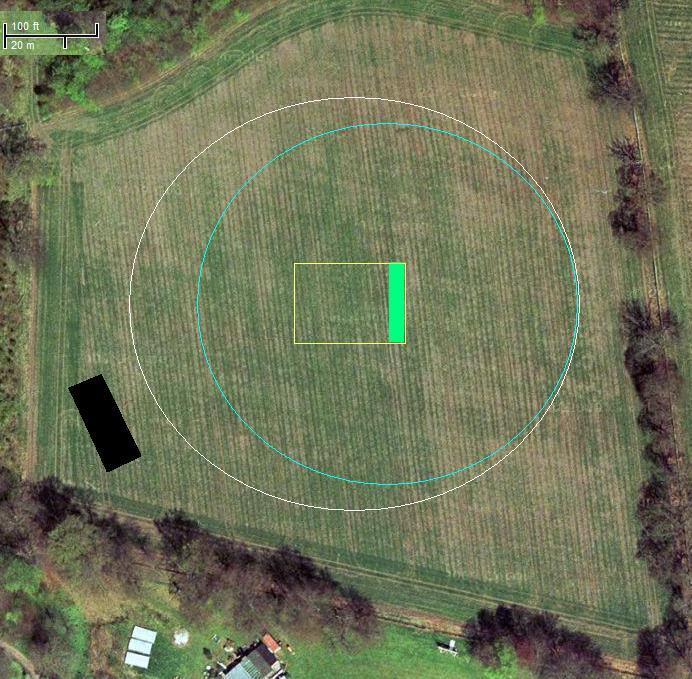

Position Falkland Activity Centre as shown in black |
Late September 2014 |
Harvest barley from remaining 95%+ |
October 2014 |
Perform groundworks to (partly) level proposed playing area and prepare ‘road’ and parking to the north of the new structure |
November 2014 |
Work can start on parts of the Falkland Activity Centre as resources become available – particularly the external changing rooms |
Spring 2015 |
Plant grass seed over all remaining area of |
Summer 2015 |
Start maintaining |
Summer 2015 |
All |
September 2015 |
Vacate School Playing Field |
October 2015 |
Install single artificial wicket on |
April 2016 |
Falkland 3rd XI and Sunday XI start playing on |
Summer 2016 |
1st & 2nd XIs continue to play on Scroggie and change in existing clubhouse, but visiting teams can use two changing rooms |
September 2016 |
Work on fitting out Falkland Activity Centre is completed |
Summer 2017 |
Grass wickets on |
There is a fair amount of
flexibility built into this plan. The timescales given above are for illustrative
purposes only. They can be accelerated if all the necessary resources become
available earlier. The one aspect which cannot change is the early September
2014 delivery of the prefabricated structure. If it doesn’t happen then it will
not happen at all.
To see the final piece of the
jigsaw – what will all this development mean to
Existing
Building |
Proposed
Structure |
Playing
Areas |
|
|
|||
|
|||
|
|
